Metal roofing installation is a large, technical project with real consequences if steps are skipped or done out of order. This guide walks through every phase of a residential metal roof installation in San Antonio from measuring and material selection through panel fastening, flashing, and final inspection so you know exactly what a proper job looks like and what to watch for whether you hire a crew or take on sections yourself.

How to install metal roofing San Antonio Metal roof installation · Step-by-step guide DIY vs professional · Cost guide · Material selection Standing seam · Corrugated · Exposed fastener Updated 2026
T
Ted
With over 30 years of residential and commercial metal roofing experience across San Antonio and Bexar County, our crews have installed thousands of metal roofs on homes and commercial properties throughout South Texas. Every guide we publish comes from real on-the-ground experience with Texas metal roofing conditions not generic contractor advice.
· affordableroofingcontractorssanantonio.com · Licensed and Insured · $2M Liability Coverage · 100+ Five-Star Reviews
Part of our complete roof maintenance guide
How to Maintain Your Roof in San Antonio | Expert Roof Maintenance Tips
$8–15/sqft
Typical installed cost range for residential metal roofing in San Antonio in 2026
2–4 days
Average professional installation time for a standard San Antonio residential metal roof
50+ yrs
Expected service life of a properly installed metal roof in the Texas climate
30+
Years of metal roofing installation experience our San Antonio crews bring to every job

Metal roofing is one of the most durable, energy-efficient, and long-lasting roofing systems available to San Antonio homeowners. When it is installed correctly, a metal roof can outlast two or three asphalt shingle replacements and handle the full range of South Texas weather, from summer heat and UV exposure to severe hailstorms and high winds. When it is installed incorrectly, it leaks, rattles, and corrodes in ways that are expensive to diagnose and fix.

This guide covers every step of a residential metal roofing installation in San Antonio: how to measure and plan your project, how to choose the right panel system for your home, how to prepare the deck and underlayment, how to install panels in sequence, and how to flash penetrations and finish the ridge correctly. Whether you are planning to hire a professional crew and want to understand what a proper installation looks like, or you are considering taking on a section of the work yourself, this is the guide to start with.

The principle that determines whether a metal roof installation succeeds or fails: sequence and system

Metal roof installation is not just about attaching panels to a deck. Every component underlayment, panels, fasteners, trim, flashing, and ridge cap is part of a tested system designed to work together. Swapping out one component for a cheaper substitute, skipping the underlayment step, using the wrong fastener gauge, or installing trim in the wrong order can compromise the entire system's weatherproofing and warranty. The steps in this guide are sequenced the way professional crews execute them in San Antonio, and that order matters. Do not skip ahead.

Metal roofing installation San Antonio Texas residential step by step
A professional metal roof installation in progress on a San Antonio residential home. Proper sequencing of underlayment, panels, and flashing is what separates a roof that lasts 50 years from one that leaks within the first five.
● ● ●
The complete installation process from start to finish
Six steps to a properly installed metal roof in San Antonio
01
Planning, measurement, and material selection get this right before anything else
Accurate takeoffs and the right panel system choice determine everything that follows
Planning

Every successful metal roof installation in San Antonio starts on paper, not on the roof. Before a single panel is ordered or a fastener is purchased, you need accurate measurements of every roof plane, a clear decision on which panel system to use, and a material list that accounts for waste, trim, and overlap. Ordering short means project delays. Ordering the wrong panel profile means you cannot complete the system as designed.

Roof measurement takeoff diagram metal roofing San Antonio

Measure every roof plane separately. For each plane, measure the horizontal run (width along the eave) and the rake length (the sloped measurement from eave to ridge). Multiply these to get the square footage of each plane, then add all planes together for the total roof area. Always add 10% to 15% for waste, cuts, and trim overlaps. A roofing square equals 100 square feet your supplier will quote materials in squares.

Measure all penetrations and edges. Count every linear foot of ridge, hip, rake edge, valley, eave edge, and any penetration (chimney, pipe, skylight, HVAC curb). These measurements drive your trim and flashing orders, which are separate line items from your panel order.

Choose your panel system before ordering anything. The three most common metal roofing systems installed on San Antonio homes are standing seam, exposed-fastener corrugated panels, and exposed-fastener ribbed panels (sometimes called R-panel or PBR panel). Each system has different installation requirements, different trim components, and different fastener patterns. You cannot mix components between systems.

Panel system Best for Minimum pitch Fastener type Typical installed cost (San Antonio)
Standing seam (concealed fastener) Long-term residential investment, low-maintenance, premium appearance 1:12 minimum, 3:12 recommended Concealed clip fasteners no penetrations through the panel face $10 to $15 per sq ft installed
Exposed-fastener corrugated Budget-conscious residential, outbuildings, secondary structures 3:12 minimum Hex-head screws with EPDM washers through panel face $8 to $11 per sq ft installed
R-panel / PBR panel Residential and light commercial, good balance of cost and durability 2:12 minimum Hex-head screws with EPDM washers through panel rib or flat $8 to $12 per sq ft installed
San Antonio-specific planning note: Texas building code requires a permit for most residential roofing replacements. Bexar County and the City of San Antonio both require permits for full roof replacements and new installations. Pull your permit before work begins not after. Installing without a permit can create problems at resale and may void your homeowners insurance coverage for work done without required inspections.

Order materials with lead time in mind. Custom-length standing seam panels and specialty colors are typically cut to order and can take two to three weeks for delivery in the San Antonio market. Standard corrugated and R-panel in common colors (Galvalume, classic bronze, charcoal, terra cotta) is usually available from local San Antonio suppliers within a few days. Confirm lead times before scheduling your installation crew or starting any tear-off work.

Planning and measurement checklist
  • All roof planes measured separately: run, rake length, and square footage calculated for each
  • Total roof area calculated in squares with 10% to 15% overage added for waste and trim
  • All linear footage measured: ridge, hips, rakes, valleys, eave edges, and each penetration perimeter
  • Panel system selected: standing seam, corrugated, or R-panel confirmed before any materials ordered
  • Building permit applied for with Bexar County or City of San Antonio before work begins
  • Material lead times confirmed custom panels ordered with enough time before scheduled install date
02
Deck preparation and underlayment installation the foundation no one sees
A sound deck and the right underlayment are what keep a metal roof watertight for decades
Deck Prep

No metal roof performs better than the deck it sits on. Before any underlayment goes down, the existing deck needs to be inspected thoroughly. Soft spots, delaminated plywood or OSB, rotted areas around old penetrations, and any sections where moisture has been sitting under the previous roof all need to be addressed before the new roof goes on. Installing over a compromised deck is one of the most common installation mistakes in San Antonio, and it is one of the most expensive to fix after the fact because it means removing panels to get to the problem.

Walk the deck: Step methodically across every section feeling for soft spots and bounce Check penetrations: Around every pipe, vent, chimney, and old flashing for rot and delamination Inspect edges: Eave and rake edges are common rot locations where water has tracked under old shingles Replace damaged panels: Use 7/16" OSB or 1/2" plywood match the existing deck thickness

Underlayment selection matters more on metal roofs than on asphalt roofs. Metal panels expand and contract significantly with temperature changes. In San Antonio, a dark metal roof can swing from 40°F in January to over 160°F in July. That thermal movement means the underlayment must be able to handle sustained heat without degrading, sticking to the underside of the panels, or releasing off-gases that cause the panels to corrode from below. Standard 15-pound felt is not appropriate for metal roofing installations and should not be used under metal panels for this reason.

Best
choice
Self-adhering rubberized membrane (peel-and-stick): Products like Grace Ice and Water Shield or equivalent peel-and-stick membranes provide a fully adhered, self-sealing underlayment that bonds to the deck. Excellent for San Antonio's combination of summer heat and occasional heavy driving rain. Required by most metal roofing manufacturers to maintain warranty coverage on the panel product.
Good
choice
Synthetic non-woven underlayment rated for metal: Products like GAF Tiger Paw, Owens Corning ProArmor, or equivalent 40- to 60-year synthetic underlayments designed specifically for metal roofing. Lighter than peel-and-stick, easier to work with, and more heat-stable than felt. A very common choice for standard residential metal roofing in San Antonio.
Avoid
under metal
Standard 15# or 30# felt paper: Not appropriate under metal panels. Felt deteriorates under sustained high heat, releases sulfur compounds that can react with zinc-aluminum coatings (Galvalume), and does not perform as a secondary weather barrier once the paper dries out and cracks. Not accepted under warranty by most metal roofing manufacturers.
Pro tip

Install your underlayment horizontally across the deck, starting at the eave and working toward the ridge, with each course overlapping the one below by a minimum of 6 inches. At valleys and penetrations, bring the underlayment up and over the valley transition rather than cutting it flush. This gives you a fully covered secondary water barrier before a single panel goes up. On steep-pitch San Antonio roofs, temporarily staple the underlayment as you go and follow immediately with your panel installation do not leave underlayment exposed in Texas summer sun for more than a few days or it will blister and delaminate from the staples.

Deck and underlayment checklist
  • Full deck inspection completed all soft spots, delaminated areas, and rotted sections identified before underlayment goes down
  • Damaged deck panels replaced with matching thickness OSB or plywood and properly fastened
  • Drip edge installed at eaves before underlayment and at rakes after underlayment this sequence matters
  • Appropriate metal-rated underlayment selected synthetic or peel-and-stick, not standard felt paper
  • Underlayment installed horizontally from eave to ridge with minimum 6-inch horizontal laps and 4-inch end laps
  • Valley and penetration areas covered fully no gaps or exposed deck visible before panel installation begins

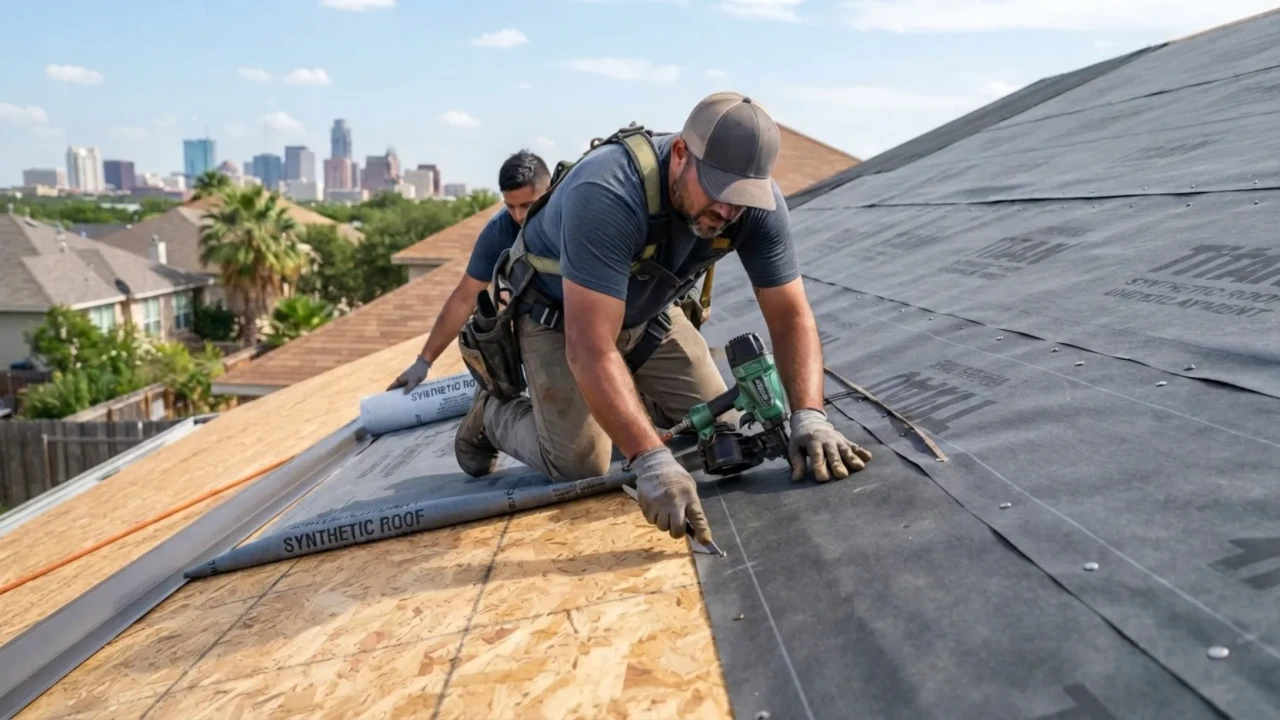

Metal roof underlayment installation synthetic membrane San Antonio deck prep
Synthetic underlayment installed on a San Antonio residential deck before metal panel installation. The peel-and-stick or synthetic membrane provides a secondary weather barrier and protects the deck from the heat and moisture that builds up under metal panels.
03
Eave trim, rake trim, and starter strip installation set the panels up to run straight
The trim you install before the first panel determines whether every panel that follows runs true
Trim and Layout

Before the first metal panel goes up, the trim components at the eave and rake edges must be installed correctly. This step is more important than it looks. The eave trim (also called drip edge or eave flashing) sets the starting edge that every panel will reference. If it is not straight and square to the rake, your panels will drift out of alignment as you work up the slope.

Install eave trim first. The eave trim runs along the bottom edge of each roof plane and gives the first panel a clean edge to sit against. It also directs water off the fascia and into the gutter rather than allowing it to wick back under the panel. Eave trim for metal roofing is typically a formed piece of the same metal as your panels, available in matching colors from your panel supplier. Fasten it to the deck edge at 12-inch intervals using the fasteners specified by the trim manufacturer for your panel gauge.

Eave trim: Installed before underlayment at the eave bottom edge on most systems Rake trim: Installed after underlayment along both sloped side edges of each roof plane Gable trim: Used at gable ends to cap the panel edge and prevent wind lift on exposed rake edges Closure strips: Foam or rubber closures that fit the panel profile and seal the eave and ridge openings against insects and water

Snap a layout line before the first panel. Once your eave trim is set, measure up from the eave at two points on the roof plane and snap a chalk line parallel to the eave. This line gives you a visual reference to keep your first panel running square. On most exposed-fastener systems, that first panel sets the alignment for every panel that follows if it is even slightly off square at the bottom, the error compounds all the way to the ridge. Take the time to get this right before you drive a single fastener into a panel.

San Antonio installation note: in South Texas, wind-driven rain events can come from almost any direction. Pay particular attention to your rake trim installation at the exposed gable ends of your roof. A rake trim that is not fully fastened and sealed against the panel rib is one of the most common entry points for wind-driven water. Use a butyl sealant tape at the contact point between the rake trim and the panel, and fasten at the intervals your manufacturer specifies do not space fasteners further apart to save time.
Trim and layout checklist
  • Eave trim installed at correct sequence before underlayment (most systems) and verified as straight and level
  • Rake trim installed along both gable edges and fully fastened at manufacturer-specified intervals
  • Foam or rubber closure strips installed at eave openings to seal panel ribs against insects and water
  • Layout line snapped on each roof plane before the first panel is placed
  • First panel checked for square using a speed square or the 3-4-5 triangle method before fastening
  • Butyl sealant tape applied at all trim-to-panel contact points per the manufacturer installation guide
04
Metal panel installation the sequence, overlap, and fastener pattern that makes it watertight
Panel direction, overlap depth, and fastener torque are the three things most DIY installations get wrong
Panel Install

With your deck prepped, underlayment down, and trim installed, you are ready to install panels. The installation sequence for most metal roofing systems runs from one rake edge to the other across the roof plane, with each panel overlapping the one before it. Direction matters: on most exposed-fastener systems, you start at the rake edge that is prevailing-wind-downwind for your area. In San Antonio, prevailing winds typically run from the south and southeast, so you would generally start at the right rake (west side) when facing the house from the front, and work left.

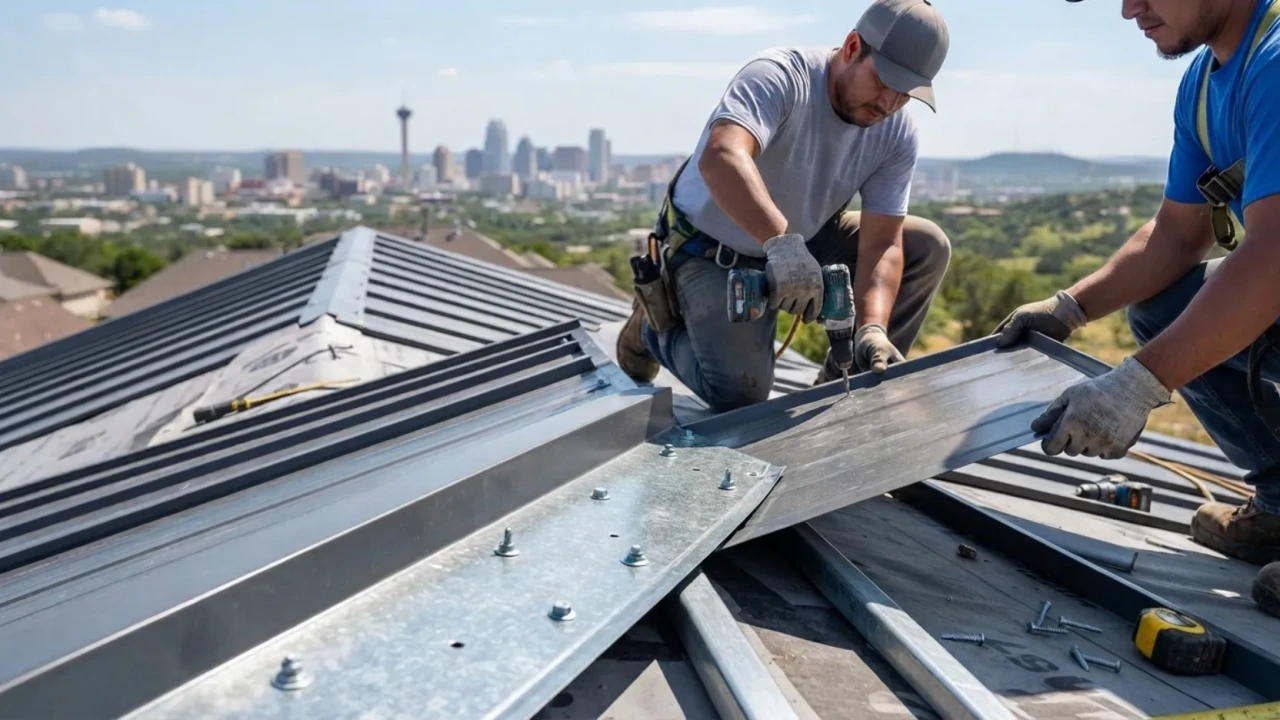

Metal roof panel installation fastener pattern overlap San Antonio

Overlap depth by system type: Corrugated panels typically overlap by one full corrugation (one rib). R-panel and PBR panel systems overlap at the male rib/female rib joint designed into the panel profile. Standing seam panels snap-lock or clip-lock together at the seam no exposed fasteners through the panel face.

Fastener torque is critical on exposed-fastener systems. The EPDM-gasketed hex-head screw must be driven to the point where the rubber washer is compressed into a slight dome shape, not completely flattened. Over-driving strips the thread, deforms the washer, and creates a leak point immediately. Under-driving leaves a gap between the washer and the panel. Set your drill or impact driver torque before you start and test on a scrap piece of panel.

Fastener placement by system: On corrugated and standard ribbed panels, fasteners go through the flat of the panel, not through the rib. Fastening through the high rib increases the risk of the fastener pulling through under wind uplift. Spacing is typically 12 to 24 inches on center along each purlin or structural member, and at every rib at the eave and ridge rows. Always fasten into structural framing fasteners into decking only are not adequate for wind uplift resistance in Bexar County's wind exposure categories.

Pro tip

Cut metal panels with aviation snips, a circular saw with a fine-tooth metal cutting blade (carbide-tipped with 60 or more teeth), or a nibbler never with an angle grinder. Angle grinders leave a hot, jagged edge covered in metal sparks that embed in the panel coating and rust within weeks. Any cut edge on a painted or Galvalume panel should be treated with a zinc-rich touch-up paint before the panel is installed. Exposed raw edges at cuts are the most common source of early rust on otherwise sound metal roofing installations, and it is a quick preventable step that protects your investment.

Step 1
placement
Place first panel at the starting rake edge, aligned with your layout line. Check for square at the eave corner. The panel should overhang the eave trim by 1 to 1.5 inches to direct water into the gutter confirm this measurement before fastening.
Step 2
fastening
Fasten the first panel starting at the eave row and working toward the ridge. Do not fasten the overlap edge until the next panel is in place. Work from the eave up so gravity helps hold the panel in position while you fasten.
Step 3
overlap
Slide the next panel into position with the correct overlap and engage the rib joint. On corrugated panels, lap one full corrugation. On R-panel, engage the male/female rib fully. Apply sealant or butyl tape at the overlap seam if specified by your manufacturer for the pitch you are working on.
Step 4
repeat
Continue across the roof plane, checking alignment every three to four panels against your layout line. Small misalignments compound quickly on a long roof plane. Adjust by slightly fanning or closing the overlap before the misalignment becomes visible from the ground.
Panel installation checklist
  • First panel placed, checked for square, and confirmed at correct eave overhang before fastening
  • Fastener torque set and tested on scrap panel before production fastening begins
  • Fasteners driven through panel flat (not rib) and into structural framing members, not decking only
  • Overlap depth consistent across each panel run confirmed before fastening the overlap edge
  • Sealant or butyl tape applied at overlap seams per manufacturer guidance for the installed roof pitch
  • All cut panel edges treated with zinc-rich touch-up paint before installation
  • Alignment checked against layout line every three to four panels and adjusted as needed

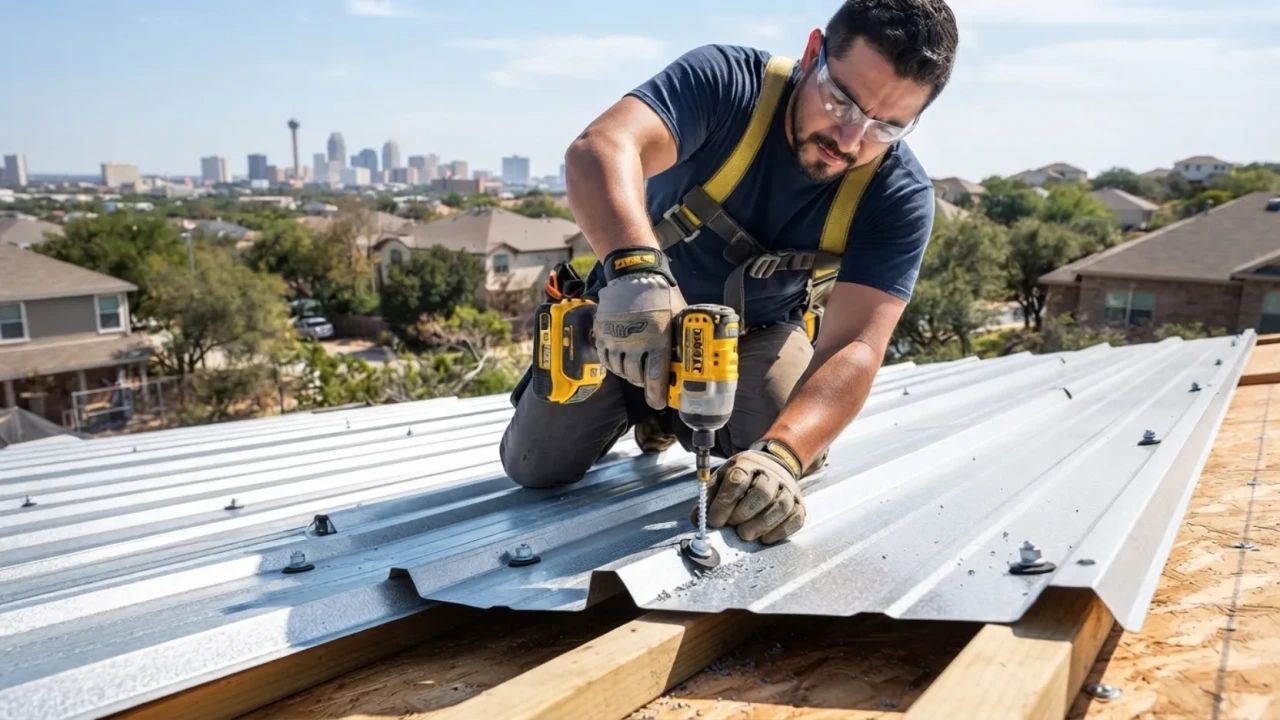

Metal roof panel fastener EPDM washer exposed fastener installation San Antonio
Properly driven EPDM-gasketed fasteners on an exposed-fastener metal roofing panel. The rubber washer should compress to a slight dome not flattened completely and not leaving a visible gap. Fastener torque is the most commonly mishandled variable in DIY metal roof installations.
05
Flashing all penetrations and transitions where most leaks start and how to stop them
Chimneys, pipes, vents, valleys, and skylights each need their own flashing sequence to stay watertight
Flashing

Flashing is the most leak-prone element of any roofing system, and metal roofing is no exception. Every place where a panel ends, changes direction, or meets another surface a chimney, a pipe, a valley, a wall, a skylight is a potential water entry point if the flashing is not installed correctly. Flashing work on a metal roof is also more demanding than on an asphalt shingle roof because metal's thermal expansion means flashing details need to accommodate movement over time.

Pipe and vent penetrations use a pipe boot: a preformed flashing collar with a flexible rubber seal that compresses around the pipe. On a metal roof, use a pipe boot designed for metal roofing with a base plate that matches or is compatible with the panel profile. The boot installs over the pipe with the base plate sitting on top of the installed panel. Seal the base plate perimeter to the panel using a urethane or silicone sealant rated for metal roofing standard caulk does not hold up under the temperature swings a San Antonio metal roof experiences. The next panel above overlaps the top edge of the boot base plate.

Pipe and vent boots: Metal-roofing-specific boots with panel-profile-compatible base plates Chimney flashing: Step flashing up both sides, counter-flashing embedded in the mortar joint Valley flashing: Open valley with formed W-valley or closed with integral panel system choose before panels are ordered Wall flashing (L-flashing): Where a roof plane meets a vertical wall flashing goes behind siding and over panels Skylight flashing: Manufacturer-supplied skylight kit do not improvise this detail

Chimney flashing on a metal roof follows the same general principle as on a shingle roof but with metal-specific considerations. Step flashing is woven between courses on a shingle roof; on a metal roof, it is replaced with a continuous piece of formed step flashing on each side, custom bent to follow the panel profile. Counter-flashing is embedded into the chimney mortar joint and lapped over the top edge of the step flashing. A proper chimney flashing detail on a metal roof takes time to execute well it is one of the details where cutting corners is most likely to produce a persistent leak.

Valley installation is chosen before your panel order is placed. Open valleys use a formed W-valley strip of matching or complementary metal running the full length of the valley, with panels on both sides trimmed to a clean line away from the center. Closed valleys integrate the panel profiles together at the valley this is more complex to execute but produces a cleaner visual result and is common on premium standing seam installations. Confirm which valley style your crew is planning to use and that your material order includes the correct valley flashing components.

The most important sealant rule for San Antonio metal roofing: never use standard painter's caulk, latex caulk, or low-grade silicone at any metal roofing flashing detail. The temperature extremes on a South Texas metal roof will cause low-grade sealants to crack and pull away within one to three seasons. Use only urethane or high-grade silicone sealants specifically rated for metal roofing applications and confirmed as compatible with your panel coating type. Your panel manufacturer's installation guide will specify which sealant products are approved.
Flashing checklist
  • All pipe boots are metal-roofing-specific and sized to match the pipe diameter at each penetration
  • Pipe boot base plates sealed to the panel with urethane or metal-rated silicone not standard caulk
  • Chimney step flashing custom bent to follow the panel profile on each side
  • Chimney counter-flashing embedded into the mortar joint and lapped over step flashing correctly
  • Valley type confirmed (open W-valley or closed) and correct flashing components installed per the design
  • Wall flashing (L-flashing) installed behind the siding and over the panel surface not under the panel
  • All skylight flashing installed using the manufacturer-supplied kit and sealed per the skylight manufacturer's instructions
  • No standard latex or painter's caulk used anywhere in the flashing detail only metal-rated urethane or silicone
06
Ridge cap, peak trim, and final inspection finishing the roof correctly and confirming it is watertight
The ridge cap is both the last piece installed and one of the most wind-critical components on the entire roof
Final Steps

Once all panels are installed and all flashings are complete, the ridge cap closes the roof at the peak. On a gable roof, the ridge cap runs the full length of the ridge from one rake end to the other. On a hip roof, ridge caps run each hip and meet at the peak. Either way, the ridge cap is exposed to full wind load and needs to be fastened securely it is one of the most common components that fails in high-wind events when it was not installed with enough fasteners or the right sealant detail at the panel interface.

Closure strips at the ridge are the first detail before the cap goes on. Foam or rubber closures shaped to match your panel profile are installed at the top edge of the last panel course on each side of the ridge. These closures fill the gap between the panel ribs and the underside of the ridge cap, blocking insects, wind-driven water, and debris from entering the attic space at the ridge line. Do not skip this step an open ridge on a San Antonio home is a direct entry point for everything from rainwater to wasps.

Foam closures: Pre-cut to match your panel profile order from your panel supplier at the same time as panels Ridge cap overlap: Minimum 6 inches where two cap sections meet at a seam Ridge fasteners: Must penetrate through the cap, closure, and panel into structural framing not just into the panel Sealant at cap seams: Butyl tape or metal-rated sealant at all ridge cap end laps

Final inspection covers the entire roof surface systematically. Walk every panel run and look for fasteners that are over-driven, under-driven, or misaligned. Check every flashing detail for gaps in sealant or lifted edges. Confirm that all trim pieces are fully fastened and that no panels have shifted during installation. At the ground level, walk around the perimeter and check for any cut panel edges left untreated, any trim pieces that are not flush, and any debris left on the roof surface that could trap moisture against the panel coating.

Safety note

Metal roofing panels are slippery, especially when wet, and extremely slippery even when dry at pitch angles above 6:12. Fall protection is not optional. Any work on a roof pitch steeper than 4:12 requires a personal fall arrest system, a safety harness, and anchoring to the structure not just roof shoes and careful movement. In San Antonio's summer heat, heat exhaustion on a metal roof is also a real risk. Plan your work schedule to avoid midday in summer months, bring water, and have someone on the ground who knows where you are working. A metal roof that you did not finish because of a fall is not worth saving the installation cost.

After the physical inspection, confirm that your installation is documented for the building permit. The City of San Antonio and Bexar County both require a final inspection sign-off for permitted roofing work. Schedule that inspection before you remove the permit card from the premises. Your contractor should handle this if you hired professional installers confirm it is included in their scope before the job starts, not after it is finished.

Ridge, trim, and final inspection checklist
  • Profile-matched foam or rubber closure strips installed at the ridge line on both panel faces before cap installation
  • Ridge cap installed with minimum 6-inch overlap at all seam joints and butyl tape or sealant at each lap
  • Ridge cap fasteners driven into structural framing not just through the panel surface
  • All panel fasteners walked and checked for correct torque over-driven and under-driven screws corrected
  • All flashing sealant details inspected for gaps, missed sections, and adhesion to both surfaces
  • All cut panel edges confirmed as treated with zinc touch-up paint
  • Roof surface cleared of all metal shavings, scrap, and debris that could trap moisture against panel coatings
  • Building permit final inspection scheduled and completed with Bexar County or City of San Antonio
● ● ●

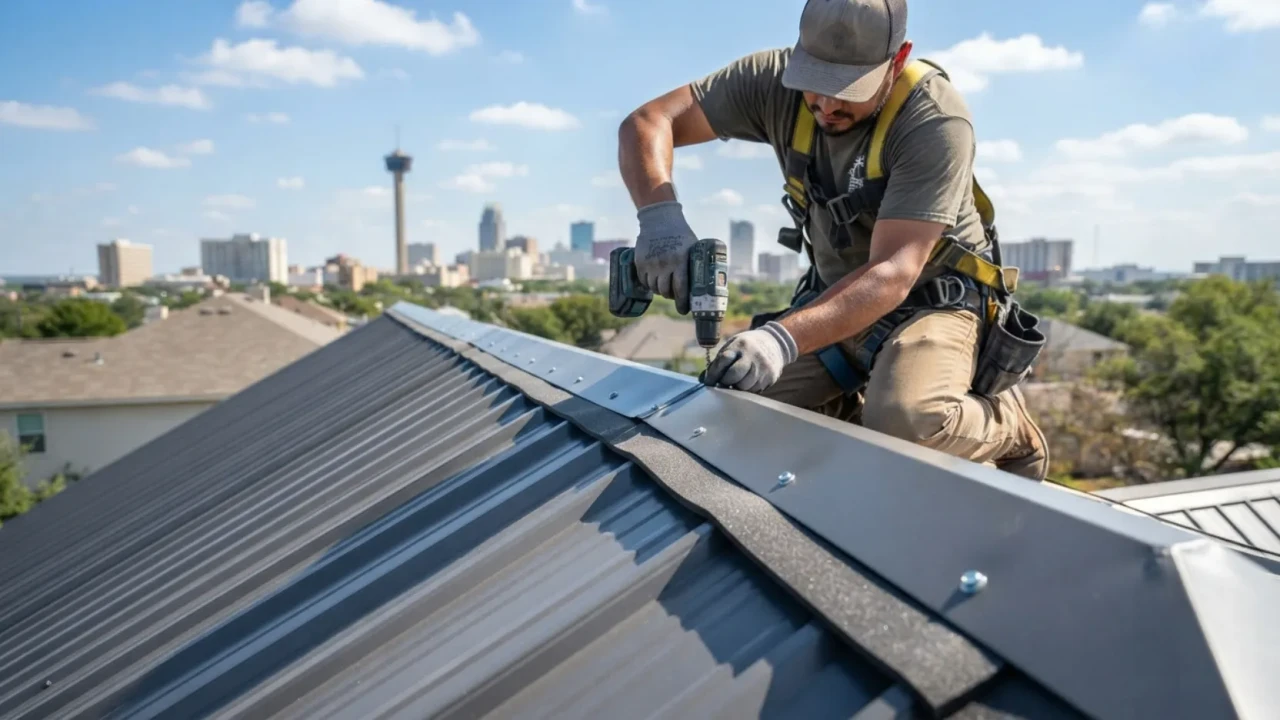

Metal roof ridge cap installation closure strip San Antonio Texas
Ridge cap installation on a San Antonio residential metal roof. The foam closure strips under the cap fill panel rib gaps to block water, insects, and debris. The ridge cap must be fastened into structural framing to resist the wind uplift forces common in Bexar County storm events.
Before you decide how to proceed
DIY vs. professional metal roof installation in San Antonio an honest comparison

Metal roofing is one of the more technically demanding residential roofing systems to install correctly. The panels are heavier and longer than shingles, the panel profiles are less forgiving of misalignment, and the flashing details require more custom fabrication than a standard shingle roof. Here is an honest breakdown of what DIY versus professional installation looks like for San Antonio homeowners.

Factor DIY installation Professional installation
Material cost Same as professional pricing from the same supplier metal panels are not discounted for DIY buyers at most San Antonio suppliers Contractors often have supplier relationships with volume pricing; savings may partially offset labor cost
Labor cost $0 in cash but significant time commitment, typically 3 to 7 days for an average residential roof with a helper $3 to $6 per square foot of installed area the labor portion of the total installed cost
Warranty coverage Most metal panel manufacturer warranties require professional installation to remain valid DIY installation typically voids the panel warranty Full manufacturer panel warranty maintained; contractor workmanship warranty also provided
Permit and inspection Homeowner can pull a permit and self-inspect, but the inspection process is the same work must meet code Licensed contractors handle permit and inspection process as part of the job
Fall risk High most residential roofing injuries happen to homeowners and helpers without proper fall protection equipment Licensed contractors carry workers compensation insurance; fall protection is standard on professional crews
Quality of flashing details Flashing is the most technically difficult part of any installation inexperienced installers most commonly produce leaks at chimney, valley, and penetration details Experienced crews execute flashing details correctly the first time fewer callbacks and no leak warranties to manage
Best use case for DIY Simple gable roof with no penetrations, minimal hips or valleys, experienced homeowner with metalworking skills, and all correct safety equipment on hand Any roof with complexity: chimneys, skylights, multiple hips and valleys, steep pitch, or a homeowner without prior roofing experience
● ● ●
Completed metal roof installation San Antonio residential home curb appeal
A completed metal roof installation on a San Antonio home. When every step from deck prep through ridge cap is executed correctly, a metal roof in South Texas delivers 50 or more years of service with minimal maintenance.
Complete metal roof installation checklist for San Antonio homeowners
Use this checklist to verify each phase whether you are managing your own installation or overseeing a professional crew
Before installation begins
  • Building permit applied for and approved do not start tear-off without a valid permit in hand
  • All roof planes measured and material quantities calculated with 10% to 15% waste factor included
  • Panel system selected and all components ordered: panels, trim, closure strips, underlayment, fasteners, flashing, and sealant
  • Material lead times confirmed and all materials on-site before installation day
  • Fall protection equipment on-site for all workers: harness, lanyard, and roof anchor rated for the pitch
  • Weather forecast checked do not start tear-off if rain is expected within 24 hours
Deck and underlayment phase
  • Old roofing removed and all existing fasteners, nails, and debris cleared from deck surface
  • Full deck inspection completed all damaged sections replaced before underlayment is installed
  • Drip edge installed at eaves (before underlayment) and rakes (after underlayment)
  • Metal-rated underlayment installed from eave to ridge with correct horizontal and end laps
  • All valleys and penetration areas covered with no gaps in underlayment coverage
Panel and trim installation phase
  • Eave trim and rake trim installed and confirmed as straight before first panel is placed
  • Layout line snapped on each roof plane and first panel checked for square before fastening
  • Fastener torque set and tested EPDM washers compressing to a dome, not flattened
  • All cut panel edges treated with zinc-rich touch-up paint before installation
  • Alignment checked every three to four panels against layout line throughout each panel run
Flashing and finish phase
  • All pipe and vent penetrations flashed with metal-roofing-specific boots and metal-rated sealant
  • Chimney flashing (if applicable) complete with correctly formed step flashing and embedded counter-flashing
  • Valley flashing installed open W-valley or closed valley per the design confirmed during material selection
  • Profile-matched foam closure strips installed at ridge and eave before cap and first panel respectively
  • Ridge cap installed with minimum 6-inch laps, butyl tape at seams, and fasteners into structural framing
  • Full roof surface walked and inspected fasteners, sealant, trim, and debris all confirmed
  • Building permit final inspection completed and sign-off received
● ● ●
Common questions answered
FAQs
Q
Can you install metal roofing over existing shingles in San Antonio?
In many cases, yes installing metal roofing over one existing layer of asphalt shingles is permitted by most building codes including Bexar County and City of San Antonio, and it is a common practice that saves the cost of a full tear-off. The conditions are that the existing shingle layer is in generally sound condition (not waterlogged, heavily buckled, or delaminated), the roof deck beneath it is structurally sound, and the total roof assembly including the new metal panels will not exceed the weight load limit for your structure. Before committing to an over-install, have a contractor walk the existing roof installing metal over a compromised shingle layer traps moisture that will accelerate deck rot and create problems that are expensive to diagnose and fix later. When in doubt, tear off and start clean.
Q
How long does it take to install a metal roof on a San Antonio home?
A professional crew installing metal roofing on a standard San Antonio residential home typically completes the job in two to four days. A simple gable roof on a one-story home with minimal penetrations can sometimes be finished in one full day by an experienced crew. More complex roofs with multiple hips and valleys, chimneys, skylights, or steep pitches take longer. A DIY installation with one or two helpers typically takes one and a half to three times as long as a professional crew plan for five to seven working days on an average-size home if this is your first metal roofing project. Weather delays are also a real factor in San Antonio, where afternoon thunderstorms in spring and summer can interrupt work schedules.
Q
Do I need a building permit to install a metal roof in San Antonio?
Yes. Both the City of San Antonio and Bexar County require building permits for full roofing replacements and new roofing installations. The permit process involves submitting your project information and, in some cases, a basic roof plan, paying the permit fee, and having the completed work inspected by a code inspector before the permit is closed out. The permit fee for a residential roofing project in San Antonio is typically a few hundred dollars depending on the scope of the work. Do not skip this step. Installing without a permit can create problems when you sell the home, may void your homeowners insurance coverage for work done without required inspections, and could require you to remove and redo work that was not inspected. A licensed roofing contractor handles the permit process as a standard part of the job.
Q
What is the minimum roof pitch for metal roofing in San Antonio?
The minimum pitch requirement depends on the panel system you choose. Standing seam panels can be installed on pitches as low as 1:12 in some product configurations, making them suitable for very low-slope residential roofs. Exposed-fastener corrugated panels have a general minimum of 3:12, and R-panel systems typically start at 2:12. Below these minimums, water can travel up the panel joints and seams through capillary action particularly relevant in San Antonio's driving rain events. Always verify the minimum pitch specification in the manufacturer's installation guide for the specific product you are purchasing, not just the general category of panel.
Q
How much does it cost to have metal roofing professionally installed in San Antonio?
The total installed cost for residential metal roofing in San Antonio in 2026 ranges from roughly $8 to $15 per square foot depending on the panel system, roof complexity, and current material pricing. Exposed-fastener corrugated and R-panel systems typically land between $8 and $11 per square foot installed. Standing seam systems run $10 to $15 per square foot installed. For an average 2,000 square foot San Antonio home with a standard gable or simple hip roof, you can expect a total project cost in the range of $16,000 to $30,000 depending on the system selected. Get at least two written quotes from licensed San Antonio roofing contractors with the scope clearly defined, including tear-off, underlayment, panels, all trim and flashing, and permit fees.
Q
What is the best type of metal roofing to install in San Antonio?
For most San Antonio homeowners, painted Galvalume steel in a standing seam or R-panel profile is the best all-around choice. Galvalume steel offers excellent corrosion resistance in the humid South Texas climate, performs well under the UV exposure and thermal cycling that San Antonio summers demand, and is available in a wide range of colors from local suppliers. Standing seam is the premium choice for homeowners focused on the lowest possible long-term maintenance cost, since the concealed fastener system eliminates the rubber washer wear points that exposed-fastener systems develop over 15 to 20 years. R-panel and corrugated systems are a solid choice for homeowners who want the durability of metal at a lower entry cost. Stone-coated steel is a good option for homeowners who want a metal roof that resembles tile or shake from the ground.
More from RRSATX: San Antonio Roofing Company
Discover more roofing tips from RRSATX, including expert advice on roof maintenance, hail damage repair, and the benefits of metal roofing for homeowners. For professional metal roofing installation and repair, visit our Metal Roofing San Antonio service page and connect with our experienced team.

Get a free metal roof installation estimate in San Antonio

Ready to move forward with a metal roof on your San Antonio home? We will walk the job, answer every question, and give you a detailed written estimate with no pressure and no obligation.
